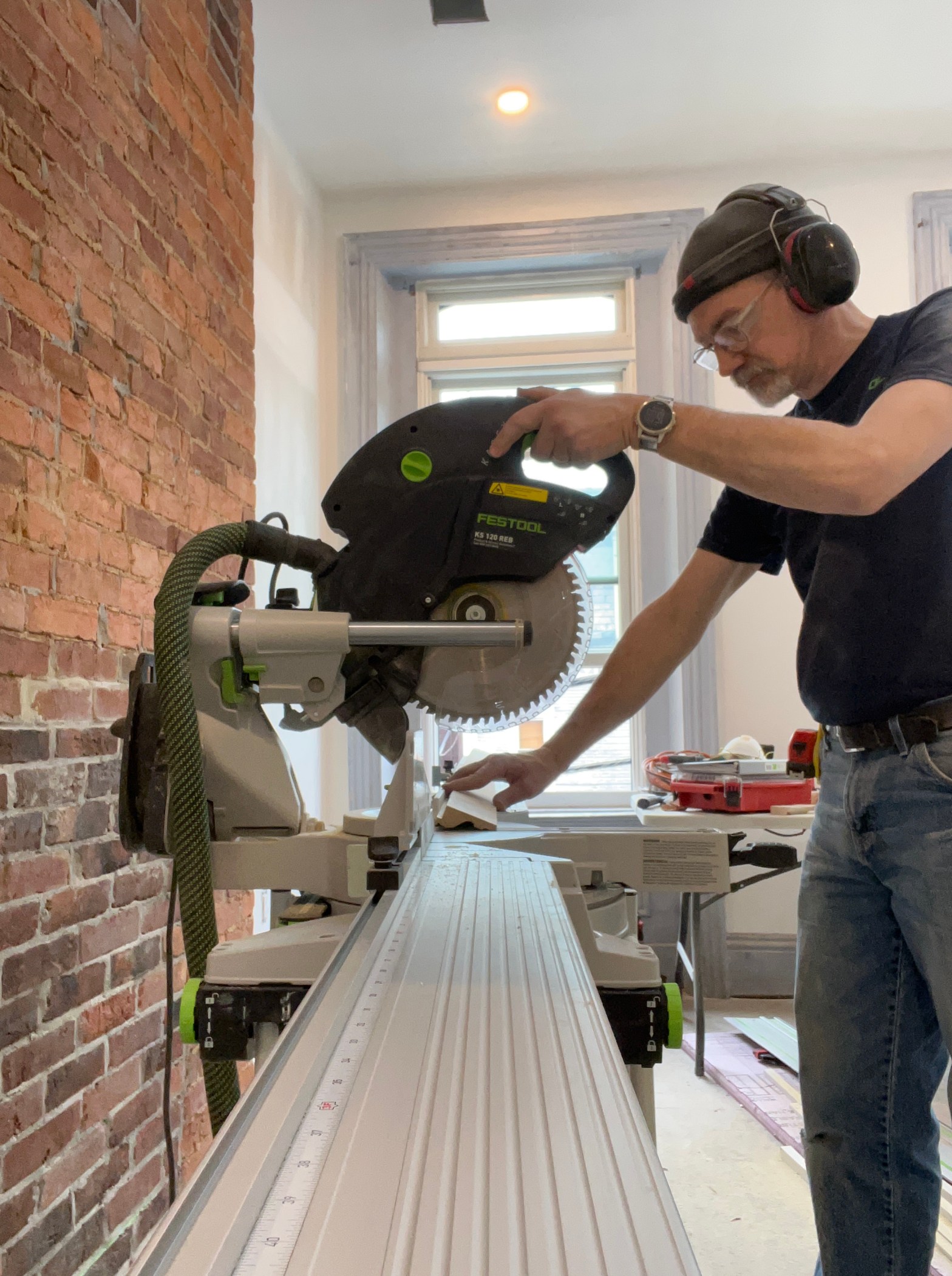

Big Picture: Where are we? Mintwood, Slower progress inside this week. Finished trim in the master vestibule and working on other trim. Splitting time with Duncan St to get the crew going there. Duncan, Demo complete, Sewer line replaced, and framing complete. Corp Update Mom is scheduled to visit starting at the beginning of March. WeContinue reading “Status Report, 28 Feb 2022”
Tag Archives: tile
Status Report, 21 Feb 2022
Big Picture: Where are we? Inside, Hanging doors have all been installed. Only had one incorrect door, and they’re already producing the replacement. Bi-folds are next for installation. Third floor is *nearly* complete.Outside, it’s been warm for a few days, but we’re getting more rain next week. Corp Update Mom is scheduled to visit starting atContinue reading “Status Report, 21 Feb 2022”
Status Report, 14 Feb 2022
Big Picture: Where are we? Inside, Doors arrived, so we are focusing on getting them installed. The team is also working to complete the sanding the stairs Outside, Still cold. Corp Update We hired a second employee effective Feb 1st. More hands, so hopefully this helps speed up some of the work on the stairs andContinue reading “Status Report, 14 Feb 2022”
Status Report, 31 Jan 2022
Big Picture: Where are we? Inside, Progressing on trim work. Painting is on ‘pause’ until we get some more trim up. Tilework is also paused. Outside, Less snow shoveling this week vs last week. Goals for Week of 24 Jan Complete tile work on second floor guest bathroom. {incomplete – see below} Complete stairwells –Continue reading “Status Report, 31 Jan 2022”
Status Report, 24 Jan 2022
Big Picture: Where are we? Inside, Trim work on third floor is complete until the doors arrive. Tile work underway in second bathroom. Sanding of stairs coming along nicely. Outside, Lots of snow this week- 12″ on the 17th, and another 4″ on the 23rd. Goals for Week of 17 Jan Complete trim work onContinue reading “Status Report, 24 Jan 2022”
Status Report, 17 Jan 2022
Big Picture: Where are we? Inside, Began tile work on second floor guest bath and also began trim work on the third floor. Outside, it’s too cold to do much other than keep it clean. Goals for Week of 10 Jan Start trim work on third floor. Should be able to complete everything that doesn’tContinue reading “Status Report, 17 Jan 2022”
Status Report, 10 Jan 2022
Big Picture: Where are we? Inside, Tile work on third floor is complete! Trim painting is underway, and we’ll start installing that next. Outside, it’s too cold to do much other than keep it clean. Goals for Week of 3 Jan Complete all tile work on third floor. Start and finish the floor, and groutContinue reading “Status Report, 10 Jan 2022”
Status Report, 03 Jan 2022
Big Picture: Where are we? Inside, We continue to work out of sequence, but progress is good. Third floor painting is complete, and tile made significant advancement. Master bath progressing also. Outside, it’s too cold to do much other than keep it clean. Goals for Week of 27 Dec Complete all tile work on thirdContinue reading “Status Report, 03 Jan 2022”
Status Report, 27 Dec 2021
Big Picture: Where are we? Inside, Focus has been on third floor tile. We also managed to get marble for the master bathroom window sill and jambs. Outside, it’s too cold to do much other than keep it clean. Goals for Week of 20 Dec Progress on master bath. A “good” outcome would be mostContinue reading “Status Report, 27 Dec 2021”
Status Report, 20 Dec 2021
Big Picture: Where are we? Inside, Kitchen cabinet install continued, but delayed on damaged materials. Electrical work continues – found an issue there also. Painting continues as well.Outside, it’s too cold to do much other than keep it clean. Goals for Week of 6 Dec arrange materials on 1st floor to maximize usable space {completed}Continue reading “Status Report, 20 Dec 2021”
